[SOLVED] How to order Kanban Entries in Backlog

More
17 Dec 2024 20:40 #1 by om
Hi,

is there a way to order the entries in the Kanban Backlog? At the moment it seems to always use the id of the entry.
At the moment I'm using a Kanban Board based on Activities and would like to order the different Activities in the Backlog (ones on the top of the list should be done next).

I've tried the following approaches:
- Use the Planning to reorder the Activities. This works nicely in the Planning view, but it doesn't seem to be possible to then use this order (wps?) for the Kanban Board. If I add wps as order to a Kanban filter but it seems to be ignored.
- Use Entry Priority (number) for ordering. This works, but it is quite hard to move tickets exactly around.

Can you give me a hint how this can be done best?

Thanks a lot and best regards,
Oliver

Please Log in or Create an account to join the conversation.

More
18 Dec 2024 10:01 #2 by maxca
Hello,

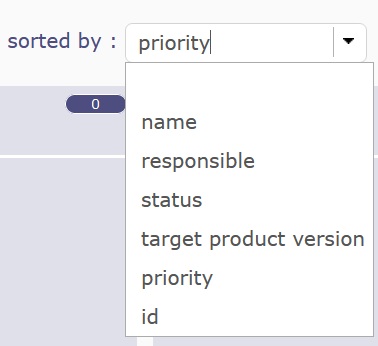

There are filters at the top to find tiles more easily or sort them with the "sorted by".


Have a nice day,
Maxca
Attachments:

Please Log in or Create an account to join the conversation.

More
18 Dec 2024 12:22 #3 by om
Thanks a lot for the hint with the "sorted by"!

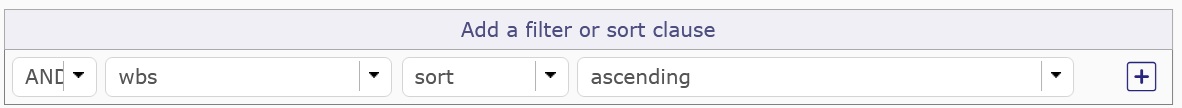

But what I still miss is a way to easily re-order individual Kanban items in the Backlog, so that the team members know which item should be done next with a short glance at the board. For example, it would be nice is to use the wbs sorting from the Activity Planning, but if I use wbs for sorting in an Advanced Filter it doesn't seem to have any effect.

Kanban and the whole Agile methology is quite centered around having a nicely ordered Backlog and I'm trying to achieve that in Projeqtor.

Attachments:
The following user(s) said Thank You: maxca

Please Log in or Create an account to join the conversation.

More
18 Dec 2024 13:14 #4 by maxca
Okay, thanks for the feedback ! I'll submit the idea.
Yes, the “Advanced Filter” doesn't work on the Backlog, the ticket has been saved. #9293 .

Have a nice day,
Maxca
The following user(s) said Thank You: om

Please Log in or Create an account to join the conversation.

More
18 Mar 2025 23:26 #5 by om
Just tested with 12.0.1 and I'm now able to use wbs to sort the items in the Activity Kanban board.
My workflow works now, I'm able to order my Activites in the Planning view and then have them ordered the same way in the Kanban Board.

Thanks a lot for the support and the fast fix!!
The following user(s) said Thank You: maxca

Please Log in or Create an account to join the conversation.

More
22 Mar 2025 10:45 #6 by kishorevenki
Can we group the Kanban board bdsed on Month or based on Resource , etc?
