View ProjeQtOr On SourceForge.net
ProjeQtOr - Project Management Tool
Supportez nous sur Capterra
OIN - Open Invention Network
ProjeQtOr free project management software - The critical path does not show the entire path - ProjeQtOr


The critical path does not show the entire path

More
30 Avr 2018 08:13 #1 by NarayanAras

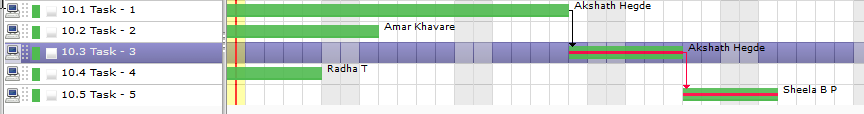

As shown in the following screenshot, the critical path does not highlight all the elements.



In this case, Task-1 should have been marked as critical (red line through it).
Attachments:

Please Connexion or Create an account to join the conversation.

More
30 Avr 2018 11:38 - 30 Avr 2018 11:40 #2 by babynus
Not sure it is (and not sure it's not).
It this task has no predecessor, it may not be on critical path.

We should see start of project to be sure.

Babynus
Administrator of ProjeQtOr web site
Last edit: 30 Avr 2018 11:40 by babynus.

Please Connexion or Create an account to join the conversation.

More
30 Avr 2018 15:07 #3 by NarayanAras
Well, all the tasks touching the left are at the start of the project (they are in ASAP mode).
But the MCP should be shown throughout the project, including the starting task.
Why does it not mark the task at the starting of the project?

Please Connexion or Create an account to join the conversation.

More
30 Avr 2018 15:17 - 30 Avr 2018 15:17 #4 by babynus
OK.
I have an idea.
Maybe it's an issue introduced when trying to fiw another issue on critical patch (as late as possible always on critical path)
Ticket #3359 recorded

Babynus
Administrator of ProjeQtOr web site
Last edit: 30 Avr 2018 15:17 by babynus.

Please Connexion or Create an account to join the conversation.

Moderators: babynusprotion
Time to create page: 0.045 seconds

Paramétrages de cookies

×

Cookies fonctionnels

Ce site utilise des cookies pour assurer son bon fonctionnement et ne peuvent pas être désactivés de nos systèmes. Nous ne les utilisons pas à des fins publicitaires. Si ces cookies sont bloqués, certaines parties du site ne pourront pas fonctionner.

Session

Veuillez vous connecter pour voir vos activités!

Autres cookies

Ce site web utilise un certain nombre de cookies pour gérer, par exemple, les sessions utilisateurs.
